Sector · Residential

Steel frame housing: precise, fast, and hurricane-rated

Homes and residential developments with steel structure fabricated to ±0.5 mm and hurricane-verified design up to 250 km/h (Cat. 4). From BIM model to dry assembly, delivered turnkey — in Colombia, Panamá, and the Caribbean.

Summary · Steel frame housing
  • Hurricane-verified design up to 250 km/h (Cat. 4) — built for coastal and Caribbean sites.
  • Dry construction up to 90% faster than traditional building.
  • Up to 30% less construction waste on your lot.
  • ZAM 180 g/m² coated steel — corrosion protection for coastal climates.
01 · The system

Why steel framing for your home.

A home that is fabricated before it is built: industrial precision, a lightweight structure, and comfort specified layer by layer.

A steel frame home begins as a BIM model and arrives at the lot as a kit of cold-formed steel (LGS/CFS) profiles, CNC-cut to a ±0.5 mm tolerance. That millimeter precision changes the build: walls arrive square, utilities run through openings planned at the design stage, and finishes sit on flat, true surfaces — none of the adjustments and waste of wet construction. The complete system, from profile to facade, is documented on the steel framing construction page.

The steel structure is also markedly lighter than traditional masonry and concrete. Less weight means smaller foundations and less mass in motion during an earthquake. And for tropical and coastal climates, the profiles use ZAM 180 g/m² coated steel, specified against corrosion, with a structural design verified up to 250 km/h winds — a Category 4 hurricane. These are the same criteria behind every SmartBrix project in Colombia, Panamá, and the Caribbean, engineered to NSR-10, REP-21, and IBC by jurisdiction.

Comfort is designed in, not improvised: every wall is specified layer by layer — exterior cladding, thermal and acoustic insulation, interior finish — for the climate and use of each room, defined in the BIM model before fabrication. And because the system allows long clear spans, the architecture gains freedom: open floor plans, future expansions, and facades tailored to the design. SmartBrix delivers the home turnkey — from design and permits through finishes — backed by 350+ delivered projects, verifiable in the projects portfolio.

02 · Advantages

Six advantages for your home.

What steel framing solves in a house — with the system's numbers, not promises.

  • 01
    Dry construction speed

    The structure is fabricated at the plant while foundations advance, and on site it is simply assembled: projects typically run 3–5 months from foundations — up to 90% faster than traditional construction.

  • 02
    Hurricane-rated 250 km/h

    Structural design verified up to 250 km/h winds — Category 4 hurricane — engineered for the Caribbean coast and the region's storm zones.

  • 03
    ZAM 180 g/m² corrosion protection

    Steel profiles with ZAM 180 g/m² coating, specified to resist tropical and coastal corrosion for the service life of the home.

  • 04
    Thermal and acoustic efficiency

    Layered wall assemblies defined in the BIM model: thermal and acoustic insulation specified room by room, before the first profile is fabricated.

  • 05
    Less waste on your lot

    Components arrive cut to size from the plant: up to 30% less construction waste, and a cleaner, safer lot throughout the build.

  • 06
    Non-combustible structure

    Steel is a non-combustible material: unlike wood-framed structures, the home's skeleton adds no fuel load to the building.

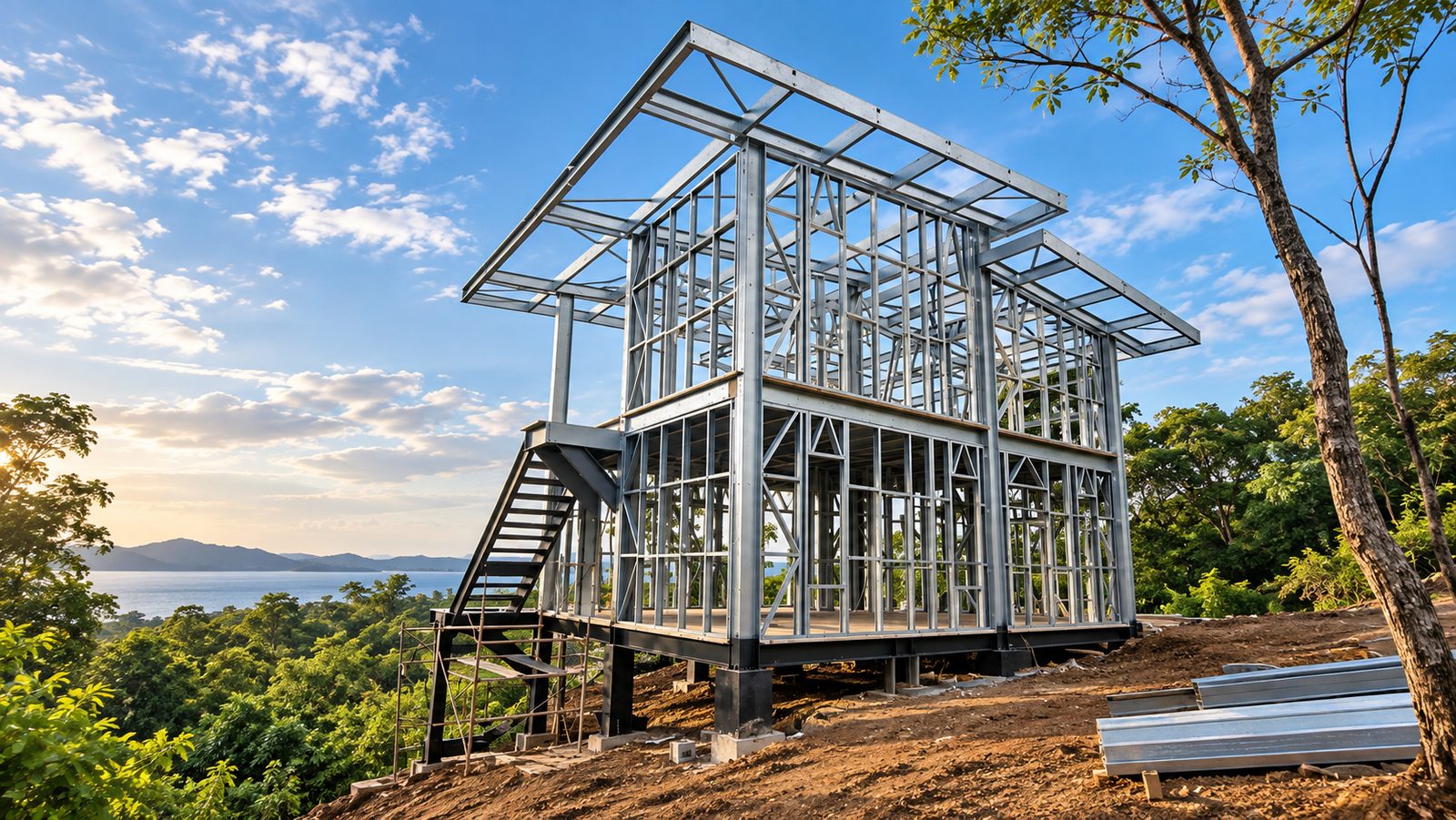

Dry assembly of steel frame home walls with CNC-cut steel profiles

Dry assembly of load-bearing walls — profiles CNC-cut to ±0.5 mm

03 · Gallery

The home on site, stage by stage.

Structure, utilities, and cladding — the real process of a steel frame home.

Structure Galvanized steel trusses and profiles during structural assembly of a steel frame home
Utilities Wet and dry utility lines installed inside the walls of a steel frame home
Cladding Exterior cladding applied over the structure of a steel frame home
MEP Electrical and plumbing installations integrated into the structure of a prefab home
04 · Quick facts

System, resistance, and timelines for a steel frame home.

The data you need to weigh the industrialized option against traditional construction.

System
Steel framing — cold-formed steel (LGS/CFS), CNC-fabricated to ±0.5 mm
Wind resistance
Hurricane-verified design up to 250 km/h (Cat. 4)
Codes
NSR-10 (Colombia) · REP-21 (Panamá) · IBC · RETIE (electrical installations) · AISI S100
Typical timeline
Months, not years: typically 3–5 months from foundations — depends on design and finishes
Delivery model
Turnkey: BIM design and engineering, fabrication, civil works, assembly, and finishes — one contract
05 · Frequently asked questions

Frequently asked questions about steel frame homes.

Is a steel frame home safe in hurricanes and earthquakes?
Yes. The structural design is verified up to 250 km/h winds — a Category 4 hurricane — and every project is engineered to the code of its jurisdiction: NSR-10, Colombia's earthquake-resistant construction code, in Colombia and REP-21 in Panamá, with profiles per AISI S100. The steel structure is also lighter than traditional construction: less mass in motion during an earthquake and lower loads on the foundation.
How much does a steel frame home cost?
As an indicative 2026 Grupo PEB Corp reference, industrialized steel structure scales with project size as follows: approx. 220–260 USD/m² for 500 m² projects, 180–220 USD/m² for 2,000 m², and 150–180 USD/m² for 5,000 m² (structure only, MEP not included). The final cost of a home depends on the design, finishes, and installations, so every project is quoted by design: request a technical proposal and get an answer within 48 hours.
How long does it take to build a steel frame home?
Typically 3–5 months from foundations — months, not years. While foundations advance on the lot, the structure is fabricated in parallel at the group's CNC plant; on site it is simply dry-assembled: up to 90% faster than traditional construction, with up to 30% less construction waste. The final timeline depends on the design, the area, and the level of finishes.
Does the steel in a steel frame home rust on the coast?
The profiles are fabricated with ZAM 180 g/m² coated steel, specified to resist tropical and coastal corrosion — the same group standard used for Caribbean projects. Coastal-city evidence: Corporación Universitaria de la Costa in Barranquilla, Colombia — 2,900 m² delivered in 3 months.

Your steel frame home, ready in months.

Tell us your project's design, area, and location — get a technical proposal within 48 hours.

Request a technical proposal →
